Materials in Costa Rica: What to Import vs Source Locally
Materials in Costa Rica. What to import, what to source locally, and why.
Most foreign owners start with the wrong question: can I get everything locally.
You can. Sometimes you should not.
The real question is this: which parts of the house require predictable performance and tight tolerances, and which parts can be sourced locally without creating drift.
This is not an ideology guide. It is not "import everything" and it is not "buy local no matter what." It is a procurement model built around how homes actually perform over time in Costa Rica.
TL;DR
The import-vs-local decision is not about preference. It is about risk placement.
- Import for predictability on performance-critical and tolerance-critical systems.
- Source locally for commodity materials and service-friendly replacements.
- The real failure mode is not local versus import. It is improvisation.
- Lock a small set of high-impact items early, then govern substitutions with clear rules.
Procurement in Costa Rica is not a shopping trip. It is a structural input that shapes timeline, budget behavior, and long-term performance. Get it right and the build feels calm. Get it wrong and every week becomes another substitution discussion.
The market reality most owners discover too late
Very little is truly produced in Costa Rica for high-performance custom homes beyond wood, cement, and PVC categories. Most other systems are imported directly or indirectly. That means many "local" purchases are still imported products, just with less transparency and less control.
For owners, this matters because "local versus import" is often a false binary. The real distinction is control. Are you controlling source, quality, lead time, and substitution standards, or are you accepting whatever is moving through the local channel that week.
Once owners understand this, procurement decisions become clearer. You are not choosing geography. You are choosing reliability under tropical operating conditions.
The 60-second decision frame
You import for predictability. You source locally for efficiency.
A serious project uses both, deliberately. Import the items that control performance and long-term behavior. Source locally where quality is consistent, service is practical, and downside risk is low.
If a team cannot explain this posture clearly, procurement will run the project instead of the project running procurement.
If you only read two sections:
Then decide whether you want the deeper detail.
The short answer: lock the few items that control durability, comfort, and schedule risk. Let commodity items float only inside a defined substitution ladder. That is how you get flexibility without chaos.
The real failure mode is not local versus import. It is improvisation.
Projects become noisy when procurement is treated like retail behavior. A strong build treats procurement as a clear system with logic, sequence, and fallback rules.
That means four things are clear before pressure shows up:
- priority: what must be locked and what can remain flexible
- timing: lead times mapped to construction phases
- equivalency: what actually counts as "similar"
- ownership: who decides when substitutions happen
Without that structure, site decisions happen under time pressure. Under time pressure, teams optimize for immediate availability. That is where timeline drift, budget drift, and quality drift usually start.
If you already read our guide on build cost numbers you can trust, this is the next layer. Cost confidence is impossible when procurement logic is vague.
What usually belongs in the import-for-predictability bucket
This is not a fixed shopping list. It is a decision model.
1) Performance-critical assemblies
Anything that materially affects long-term comfort and durability belongs here. In tropical coastal conditions, envelope and moisture performance are not decorative upgrades. They are the core of ownership quality.
Examples often include high-performance glazing systems, specific waterproofing layers, key thermal-control components, and products where minor quality variance creates major downstream consequences.
If you will only discover failure after handover, that item is a predictability candidate.
2) Tolerance-critical systems
These are the places where "close enough" becomes future pain. Large opening systems, precise hardware assemblies, and interfaces where movement and water meet typically require tighter manufacturing discipline than local supply can consistently guarantee.
Two products can look nearly identical at delivery and behave completely differently by year two. This is why visual similarity is a weak procurement standard.
3) High downside-if-wrong items
If an incorrect choice forces invasive rework later, import discipline is often worth the logistics burden. Wrong tile is usually a nuisance. Wrong membrane or wrong opening system can become structural rework and long-term operational frustration.
Owners often underestimate this because failure is delayed. Procurement decisions feel abstract in preconstruction, then become very real when remediation starts.
What usually belongs in the local-efficiency bucket
1) Commodity materials
Concrete, rebar, block, standard conduit, and other commodity materials are typically better sourced locally. Quality is generally adequate for intended use when properly verified, and importing them usually adds cost and complexity without proportional performance gain.
2) Serviceability-first components
Some items are strategically local because replacement speed matters more than premium specification. If a component might need service in three years, local availability can outperform imported perfection in practical ownership terms.
3) Heavy, bulky, low-precision goods
Where freight burden is high and tolerance requirements are low, local sourcing usually wins. The key is validating consistency, not blindly assuming it.
Sustainability is not a local-materials slogan
"Use local materials" sounds responsible. Sometimes it is. Sometimes it is just a cleaner sales line for lower predictability. In Costa Rica, sustainable outcomes usually come from performance and longevity, not origin stories alone.
A house that needs constant cooling because envelope decisions were weak is not sustainable. A home that requires recurring replacement cycles from early degradation is not sustainable. A short procurement win that creates a long maintenance debt is not sustainable.
The practical question is not where the material comes from. It is whether the building behaves well for ten years with sane operating cost and sane maintenance effort.
Wood deserves its own decision logic
Exterior wood is where many projects either become exceptional or become expensive maintenance stories. The failure mode is not "wood is bad." The failure mode is treating wood like a finish, not a system.
On paper, local wood sounds like the obvious answer. In practice, local supply quality is highly inconsistent. We regularly see material cut too early, drying handled loosely, and final QC on delivery treated as optional. Beautiful boards on day one can become movement and stability problems later.
Success requires chain discipline:
- species and source quality
- drying and preparation standards
- detailing for drainage and movement
- fastener and interface compatibility
- explicit maintenance protocol from day one
When one link is weak, owners see checking, movement, and premature aging. The wood itself is often blamed when the real issue is procurement and detailing discipline.
For this reason, we import most of our wood categories. Not all, but most. The goal is consistency in curing, milling, and delivery quality so installation decisions are based on stable inputs.
Cement quality and concrete control are separate decisions
Owners often hear "concrete is local and competitive" and assume this category is simple. It is not. There are two distinct control points:
- cement source quality: brand and consistency directly affect strength outcomes
- concrete production control: how cement is turned into placed concrete on your site
The second point is where many projects lose reliability. Ready-mix trucks are often assumed to be automatically better because they look industrial and standardized. In reality, owners usually have limited control over final water additions, additive behavior, and real-time mix adjustments once trucks are dispatched, especially when travel distances are long and heat is high.
When concrete is coming from far away in hot conditions, workability management can become a field compromise. That compromise can directly affect strength behavior.
Our operating conclusion has been straightforward: for critical pours, we get more reliable control by mixing on site under our own standards. This is not about theory. It is about repeatability when performance matters.
The local-imported paradox owners do not see at first
Many locally purchased products that are "imported" fall into two recurring buckets:
- high-volume imports: widely used, visually attractive, often weak in long-term performance
- specialized imports: acceptable quality, but very high local resale pricing due to low volume
This creates a bad choice set for uninformed owners. Cheap and common but fragile, or decent quality at inflated local cost. That pricing structure is one reason many serious builders eventually build their own import channels.
It can feel surprising, but in Costa Rica custom construction, execution quality often requires import-export competence. Procurement discipline is not a support function here. It is core construction capability.
A Costa Rica Micro-Story
One project was handed over with striking exterior wood features that became the signature of the house. Eighteen months later, sun-facing elevations showed uneven weathering and checking. The immediate assumption was poor material quality. The actual issue was process: no explicit sealing cycle, no documented maintenance rhythm, and no defined responsibility for first-year follow-up. Once a structured maintenance protocol and corrected treatment sequence were installed, behavior stabilized. The cost was manageable. The frustration cost was larger because it felt avoidable.
What to lock early vs what can float
This is where experienced teams separate from reactive teams.
Lock early
Lock anything that controls downstream decisions or sequence-critical risk:
- envelope and opening systems that affect comfort and moisture behavior
- long lead-time items that can add months if ordered late
- multi-trade interface items where late change forces resequencing
- core performance posture choices that define long-term livability
Late locking is often presented as flexibility. In practice it is usually deferred risk.
Can float, if governed
Some choices can remain open if governance exists:
- equivalency standard: performance-first definition of "equivalent"
- substitution ladder: approved A, acceptable B, escalation C
- approval boundaries: clear rules for what needs owner sign-off
"Can float" never means "we will figure it out later." It means there is a rule set for later.
Substitutions: where procurement becomes drift
Substitutions are normal. In Costa Rica, they are often unavoidable. The quality of the project depends on how substitutions are handled when they happen.
A serious substitution protocol includes:
- documented equivalency criteria (performance, durability, serviceability)
- predefined substitution ladder tied to risk level
- written change log showing what changed and why
- owner approvals only for high-impact moves
Without this, every unavailable item becomes an emergency. Emergency decisions under schedule pressure almost always degrade one of three things: timeline, budget, or performance.
If you want the contract-structure lens on this, pair this guide with fixed price vs cost-plus in Costa Rica. Procurement behavior is heavily shaped by contract incentives.
Procurement timeline math most owners miss
One of the most expensive misunderstandings in Costa Rica construction is treating procurement timing like a parallel track that can always catch up. It usually cannot.
For sequence-critical categories, the decision timeline sits ahead of the construction timeline. If a component has a 14-week lead time and you need it on site at week 20, the latest safe decision point is closer to week 6, not week 18.
That sounds obvious when written. It is easy to miss in live projects because teams often discuss these decisions in visual terms, not sequencing terms. You hear "we are still finalizing openings" when what is really true is "we are consuming the only window where this choice can arrive on time."
Procurement timing usually fails in three predictable ways:
- optimism lead-time assumptions: best-case shipping windows treated as baseline
- design-lag decisions: selections postponed until drawings feel "fully done"
- approval bottlenecks: owner decision gates that are not mapped to lead-time reality
The result is usually not one dramatic delay notice. It is silent compression. Install windows move. Interior sequence shifts. Mechanical rough-in gets resequenced. Finishes wait. Schedule confidence erodes.
Strong teams counter this by mapping selection deadlines backward from required on-site dates and showing owners exactly which decisions are sequence-critical versus cosmetic-timing-flexible. This is a huge stress reducer for remote clients because it turns "urgent requests" into predictable decision windows.
Owner decision sequence: keep influence high, keep noise low
Owners often think procurement control means giving up design influence. It does not. It means placing influence where it has the highest impact and avoiding decisions that are late enough to create collateral damage.
A practical owner sequence usually looks like this:
- Lock performance posture first: envelope logic, opening strategy, durability priorities, maintenance posture.
- Lock sequence-critical categories second: any item with long lead times or multi-trade dependency impact.
- Refine visual layers third: finishes and aesthetics inside already-stable assemblies.
- Keep low-impact categories flexible last: choices that can float without resequencing or performance loss.
When this order is reversed, owners feel busy but less in control. They make many micro-decisions yet still face avoidable surprises because the high-impact decisions were deferred.
If you are remote, this sequence matters even more. Distance amplifies every late decision because review loops are slower and site visibility is lower. A disciplined sequence protects your influence where it matters and reduces decision fatigue where it does not.
You do not need more procurement decisions. You need better-timed procurement decisions.
What serious owners can ask in one meeting
You can pressure-test procurement maturity quickly with the right questions:
- What do you lock before construction starts, and what do you intentionally leave flexible?
- How do you classify items as performance-critical versus commodity?
- Show me your substitution standard for one high-risk category.
- How do you map long lead-time imports against construction sequence?
- Who owns final calls when an item is unavailable under schedule pressure?
Strong teams answer clearly in process language. Weak teams answer in reassurance language.
How we structure this at Edificio
We run procurement as a controlled system, not a series of purchase events.
Early in preconstruction, we classify items into risk buckets and lock sequence-critical components with supplier validation, lead-time mapping, and substitution ladders already defined. For local commodities, we use verified supplier channels and quality checkpoints so local sourcing is efficient without being loose.
Owner selection windows are tied to the build sequence so decisions arrive when procurement can still absorb them without compressing execution. This is how we keep choice and control without creating late-stage chaos.
Over the last decade, we built a direct import-export pipeline because local market structure required it. That did not happen as a branding decision. It happened as an execution necessity to control quality, timing, and cost on the categories that matter most.
Procurement control snapshot:
| Category | Primary sourcing posture | Control mechanism |
|---|---|---|
| Large opening systems | Import-first | Lead-time lock + approved substitution ladder |
| Commodity structure inputs | Local-first | Supplier verification + receiving quality checks |
| Exterior wood features | Hybrid by species and chain quality | Source qualification + maintenance protocol from design stage |
This is the practical difference between "we source materials" and "we operate procurement."

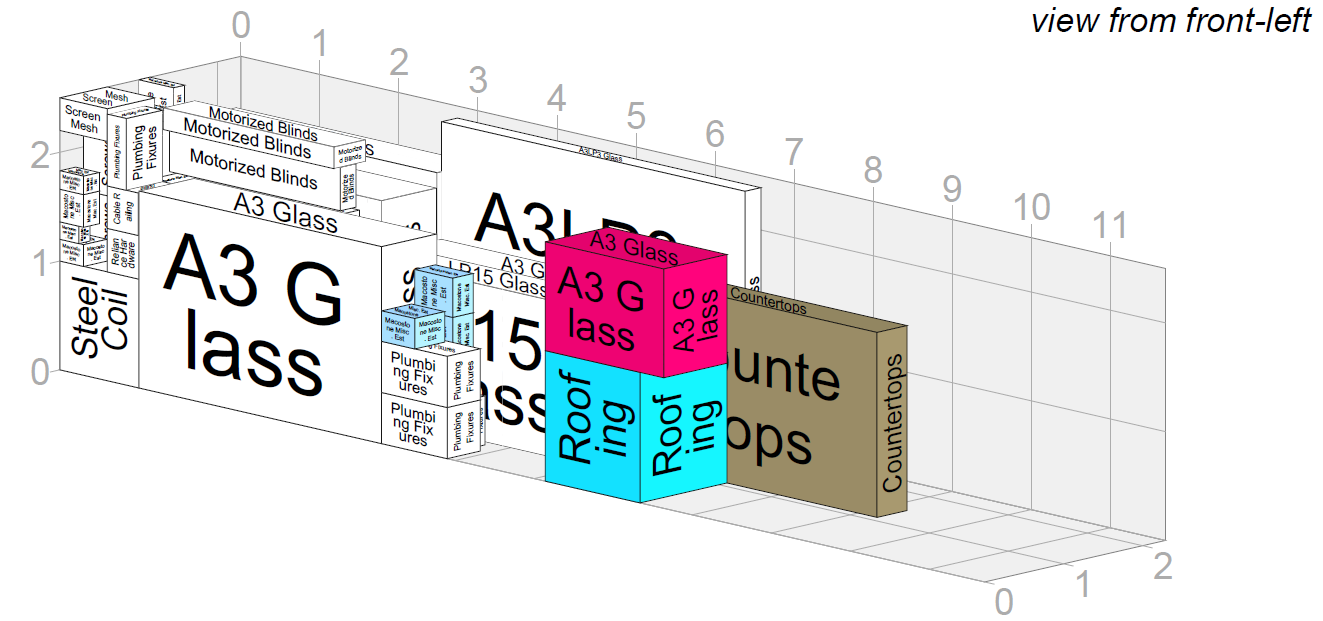

Proof artifact: PACVOL container loading plan
This model is how we stage imported categories before shipment so sequence-critical systems arrive in the right order instead of as ad hoc deliveries.
A quick scan for serious owners
If you only spend one minute here, use this.
Green Flags
- ✓ Team can explain import-vs-local logic in under two minutes.
- ✓ Long lead-time items are identified and locked before build pressure.
- ✓ Substitution standards are written and performance-based.
- ✓ Selection windows are tied to schedule, not ad hoc availability.
- ✓ Local sourcing includes quality verification, not just convenience.
- ✓ Owner approvals are reserved for high-impact changes.
Red Flags
- ✗ "We can get everything here" with no category logic.
- ✗ "We import everything" with no efficiency logic.
- ✗ No distinction between performance-critical and commodity items.
- ✗ Substitutions handled as live negotiations every time.
- ✗ Long lead times discovered only when item is needed on site.
- ✗ Procurement framed as shopping instead of system ownership.
Need a procurement sanity check before design gets too far?
In a private consult, we can map which categories in your project should be locked early, which can remain flexible, and where substitution rules should be defined before schedule pressure starts.
FAQ
What building materials should I import to Costa Rica for a custom home?
Import materials where predictable performance matters most, especially for performance-critical assemblies, tolerance-sensitive systems, and items with high downside if wrong. Use local sourcing for lower-risk commodity categories.
Is it cheaper to buy building materials locally in Costa Rica?
For commodity inputs, local is often cheaper and more practical. For high-risk performance items, local savings can be false economy if quality variance creates future rework or maintenance burden.
How long does it take to import construction materials to Costa Rica?
Lead times commonly range around 10 to 18 weeks depending on system type, supplier, and shipping windows. This is why sequence-critical items need early lock decisions.
Can I use local wood for exterior applications in Costa Rica?
Yes, if source quality, drying standards, detailing, and maintenance protocol are all controlled. Wood performance is a system question, not only a species question.
What is the biggest procurement mistake in Costa Rica construction?
Treating procurement like shopping. Reactive buying without substitution governance and lead-time planning is the fastest path to drift.
Should I hire a separate procurement agent for my Costa Rica build?
Integrated design-build teams usually produce cleaner outcomes because procurement, sequencing, and execution accountability stay unified. Splitting procurement can create coordination gaps if ownership boundaries are unclear.
How do I compare two builders on procurement capability?
Ask each team what they lock early, how they define equivalency, how substitutions are approved, and how long-lead items are mapped to schedule. Compare their process clarity, not just their price claims.
The best procurement posture is rarely all-local or all-import. It is deliberate, category by category.
If your team can show why each decision sits where it sits, procurement becomes quiet and predictable. If they cannot, procurement becomes the loudest part of the project.
If you want to see how we think in real projects, browse our completed work and client feedback in the gallery.
If you want a clear import-vs-local map for your project before decisions harden, we can build that with you in a private consult.
